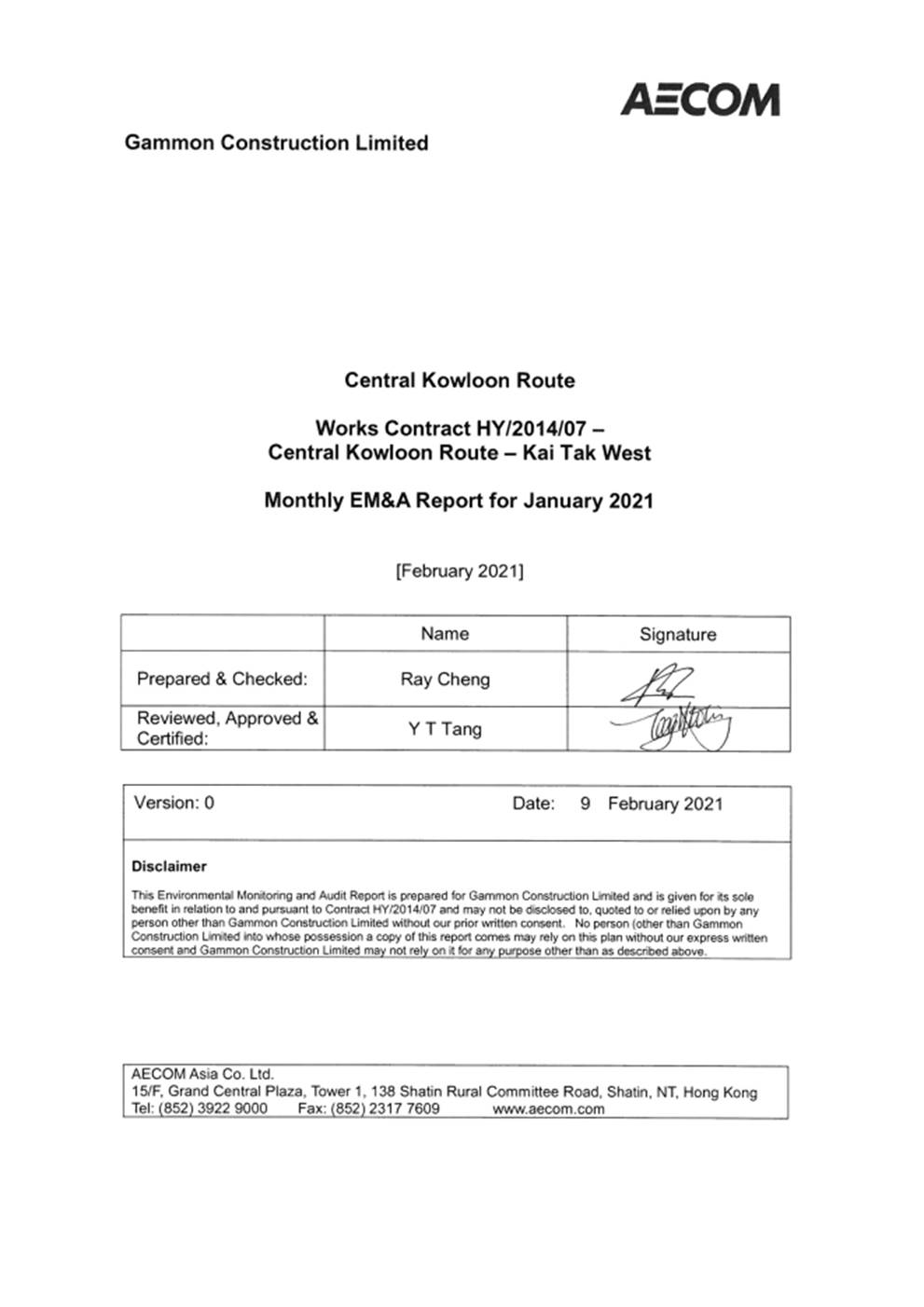

Monthly Summary Waste Flow Table Shatin to Central Link (Hung Hom – Admiralty Section) Kai Tak Barging
Facility under FEP-01/436/2012/F Monthly EM&A Report for January 2021 |
Central Kowloon Route

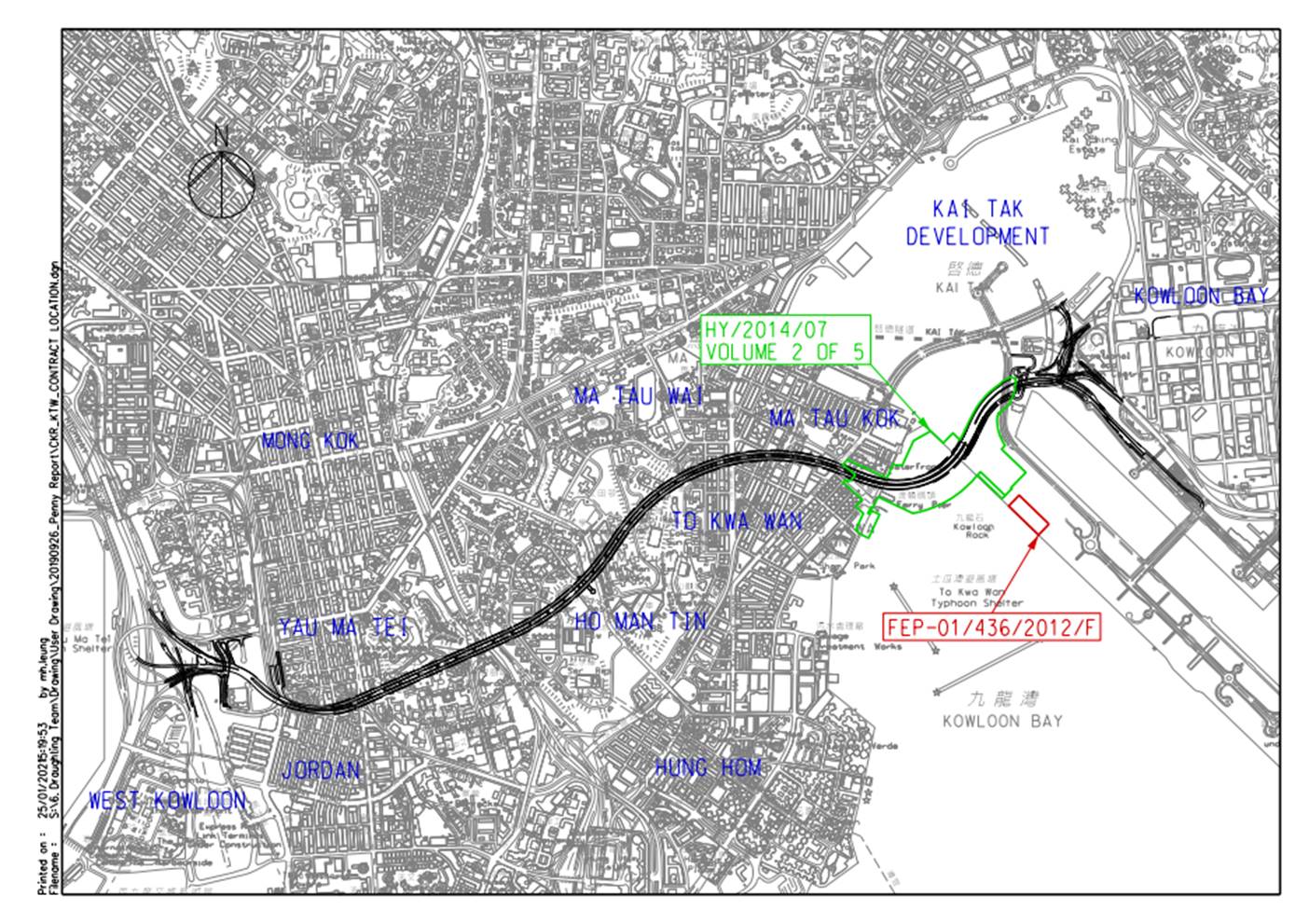

– Kai Tak West (CKR-KTW; Contract No. HY/2014/07) (hereafter called “the
Project”) covers part of the construction of the Central Kowloon Route (CKR).
The Project comprises
the follow works:
·
50x30m
access shaft with noise enclosure at Ma Tau Kok (MTK);
·
100m long
cut-and-cover (C&C) tunnel at MTK;
·
Demolition
and re-provisioning of MTK Public Pier;
·
160m long
underwater tunnel (UWT) (Stage 1);
·
210m long
UWT (Stage 2);
·
60m long
C&C tunnel at Kai Tak;
·
130m long
depressed road and 200m long underpass at Kai Tak;
·
390m long
underground tunnel ventilation adit at Kai Tak;
·
Seawall
demolition and construction of new landing steps; and
·
Barging
Point enclosure and conveyor system.
The EM&A programme commenced on 4 April 2018.The impact EM&A for the Project includes
air quality and noise monitoring.
This is the
thirty-fourth monthly EM&A Report presenting the EM&A works carried out
during the period between 1 and 31 January 2021. As informed by the Contractor,
major activities in the reporting period were:
Locations |
Site Activities |
Kai Tak |
·
Casting tunnel wall at underpass and ventilation adit; ·
Wall and roof slab construction at cut & cover,
underpass and depressed road; ·
Backfilling at Underpass and depressed road; ·
Removal of ELS at cut & cover, underpass and depressed
road; ·
Falsework erection at cut & cover, underpass and
depressed road. |
Ma Tau Kok |
·
TTM implementation; ·
Fresh water pipe installation works; ·
Constrcution of MTK traffic deck. |
Kowloon Bay |
·
Concrete packing between wailing and CPP Wall; ·
Tunnel wall construction; ·
Waterproofing application; ·
ELS Removal. |
Barging Point |
·
Barging point operation (Spoil Disposal) |
|
Breaches of Action and Limit Levels for Air Quality
All 24-hour TSP result was below the Action
and Limit Levels at all monitoring locations in the reporting month.
All 1-hour TSP result was below the Action and
Limit Levels at all monitoring locations in the reporting month.
Breaches of Action and Limit Levels for Noise
Regular Noise Monitoring
No exceedance of Action and Limit Level of noise was
recorded in the reporting month.
Complaint, Notification of Summons and Successful Prosecution
No environmental related complaints,
notification of summons and successful prosecution were received
in the reporting month.
Reporting Changes
No report changes in the reporting period.
Future Key Issues
Key issues to be considered
in the next three months included:
Locations |
Site Activities |
Kai Tak |
·
Wall and roof slab construction at cut & cover,
underpass and depressed road; ·
Backfilling works and ELS removal at cut & cover, underpass
and depressed road; ·
Dismantle of working platform. |
Ma Tau Kok |
·
TTM implementation; ·
Pipe piling works for cut and cover tunnel east portion; ·
Trial trench for piling works; ·
Fresh water pipe installation works; ·
Temporary storm drain diversion works; ·
Demolition of Kowloon City Public Pier. |
Kowloon Bay |
·
Backfilling and ELS removal works; ·
Roof slab and wall construction; ·
Waterproofing application; ·
Preparation works for Stage 2 UWT. |
Barging Point |
·
Demolition of Kai Tak Barging Point. |
|
·
Section 1:
Introduction
·
Section 2:
Project Information
·
Section 3:
Environmental Monitoring Requirement
·
Section 4:
Implementation Status of Environmental Mitigation Measures
·
Section 5:
Monitoring Results
·
Section 6:
Environmental Site Inspection and Audit
·
Section 7: Environmental Non-conformance
·
Section 8:
Future Key Issues
·
Section 9:
Conclusions and Recommendations
(a) construction of approximately 160m long cut-and-cover tunnel and
370m long underwater tunnel between the tunnel section at Ma Tau Kok and the
depressed road of the CKR within Kai Tak Development;
(b) reconstruction of the seawall at Ma Tau Kok public pier, and the
sloping seawall at the Former Kai Tak Airport Runway;
(c) construction of approximately 125m long depressed road and 200m
long underpass of the CKR within Kai Tak Development;
(d) construction of approximately 360m long underground tunnel
ventilation adit of the CKR;
(e) reconstruction of Kowloon City Ferry Pier Public Transport
Interchange; and
(f) other associated works.
Table 2.1 Construction Activities in the reporting month
Locations |
Site Activities |
Kai
Tak |
·
Casting tunnel wall at underpass and ventilation adit; ·
Wall and roof slab construction at cut & cover,
underpass and depressed road; ·
Backfilling at Underpass and depressed road; ·
Removal of ELS at cut & cover, underpass and depressed
road; ·
Falsework erection at cut & cover, underpass and
depressed road. |
Ma
Tau Kok |
·
TTM implementation; ·
Fresh water pipe installation works; ·
Constrcution of MTK traffic deck. |
Kowloon
Bay |
·
Concrete packing between wailing and CPP Wall; ·
Tunnel wall construction; ·
Waterproofing application; ·
ELS Removal. |
Barging
Point |
·
Barging point operation (Spoil Disposal) |
|
Table 2.2 Contact Information of Key Personnel
Party |
Role |
Position |
Name |
Telephone |
Fax |
Arup-Mott
MacDonald Joint Venture |
Residential
Engineer (ER) |
Engineer’s
Representative |
Mr. Jeffrey
Lau |
2268 3640 |
2268 3954 |
ERM |
Independent Environmental
Checker (IEC) |
Independent
Environmental Checker |
Ms. Mandy To |
2271 3313 |
2723 5660 |
Gammon |
Contractor |
Contracts Manager |
Mr. Alan Yan |
2516 8823 |
2516 6260 |
Environmental Manager |
Ms Michelle Tang |
9267 8866 |
2516 6260 |
||
AECOM |
Contractor’s
Environmental Team (ET) |
ET Leader |
Mr. Y T Tang |
3922 9393 |
2317 7609 |
Table 2.3 Status of Environmental Licenses, Notifications and Permits
Permit / License No. / Notification/
Reference No. |
Valid Period |
Status |
Remarks |
|
From |
To |
|||
Further Environmental Permit |
||||
FEP-01/457/2013/C |
28 Feb 2018 |
End of Project |
Valid |
-- |
Wastewater Discharge License |
||||
WT00030290-2018 |
22 Mar 2018 |
31 May 2023 |
Valid |
Ma Tau Kok |
WT00030668-2018 |
27 Apr 2018 |
30 Apr 2023 |
Valid |
Site Office at
Kai Tak West |
WT00030358-2018 |
27 Apr 2018 |
30 Apr 2023 |
Valid |
Kai Tak West |
WT00030333-2018 |
27 Apr 2018 |
30 Apr 2023 |
Valid |
Barging Point
at Portions 4B & 4C |
WT00030330-2018 |
27 Apr 2018 |
30 Apr 2023 |
Valid |
Kowloon Bay |
Construction Noise Permit |
||||
GW-RE0709-20 |
27 Aug 2020 |
26 Feb 2021 |
Cancelled |
Barging Point Operation at
Kai Tak Barging Point |
GW-RE0891-20 |
5 Nov 2020 |
4 Feb 2021 |
Valid |
General Works at Ma Tau
Kok |
GW-RE0874-20 |
20 Oct 2020 |
14 Apr 2021 |
Superseded on
20 Jan 2021 |
General Works at Kai Tak |
GW-RE0012-21 |
20 Jan 2021 |
10 Jul 2021 |
Valid |
General Works at Kai Tak |
GW-RE0989-20 |
25 Nov 2020 |
20 May 2021 |
Valid |
ELS Removal at Stage 1 UWT |
GW-RE0761-20 |
1 Oct 2020 |
31 Mar 2021 |
Valid |
Kai Tak Haul Road |
Chemical
Waste Producer Registration |
||||
5118-247-G2347-47 |
30 Jan 2018 |
End of Project |
Valid |
-- |
5118-247-G2347-48 |
30 Jan 2018 |
End of Project |
Valid |
-- |
Marine Dumping Permit |
||||
EP/MD/21-038 |
8 Oct 2020 |
7 Apr 2021 |
Valid |
Sediments requiring Type 1
- Open Sea Disposal |
Billing Account for Construction
Waste Disposal |
||||
7029909 |
22 Jan 2018 |
End of Project |
Account Active |
-- |
7031949 |
27 Nov 2020 |
26 Feb 2021 |
Account Active |
Billing Account for Disposal of
Construction Waste (by vessels) |
Notification Under Air Pollution
Control (Construction Dust) Regulation |
||||
429442 |
5 Jan 2018 |
5 Jul 2025 |
Notified |
-- |
|
Monitoring Requirements
Monitoring Equipment
Table 3.1 Air Quality Monitoring
Equipment
Tisch
Total Suspended Particulate Mass Flow Controlled High Volume Air Sampler |
|
Calibration
Kit (24-hour
TSP) |
TISCH
Environmental Orifice |
Portable
direct reading dust meter |
Sibata
Digital Dust Monitor |
Monitoring Locations
Table 3.2 Location of Construction
Dust Monitoring Station
Location |
Monitoring Station |
Description |
E-A14a
[1] |
Block
B of Merit Industrial Centre |
Rooftop
(13/F) |
[1] The air monitoring station
proposed in the EM&A Manual (i.e. Wyler Gardens with ID: E-A14) was not
available for impact dust monitoring, therefore impact monitoring was conducted
at E-A14a as an alternative which was agreed by the ER, IEC and EPD.
Monitoring
Methodology
(a)
The HVS
was installed in the vicinity of the air sensitive receivers. The following criteria were considered in the
installation of the HVS as far as practicable: -
(i)
A horizontal platform with
appropriate support to secure the sampler against gusty wind was provided.
(ii)
Two samplers should
not be placed less than 2m apart from each other;
(iii)
The distance between the HVS and
any obstacles, such as buildings, was at least twice the height that the
obstacle protrudes above the HVS.
(iv)
A minimum of 2 meters separation
from walls, parapets and penthouse for rooftop sampler.
(v)
A minimum of 2 meters separation
from any supporting structure, measured horizontally is required.
(vi)
No furnace or incinerator flues
nearby.
(vii)
Airflow around the sampler was
unrestricted.
(viii)
The sampler was located more than
20 meters from any dripline.
(ix)
Any wire fence and gate, required
to protect the sampler, did not obstruct the monitoring process.
(x)
Permission was obtained to set up
the samplers and access to the monitoring station.
(xi)
A secured supply of electricity
was obtained to operate the sampler.
(b)
Preparation
of Filter Papers
(i)
Glass fibre filters, G810 were
labelled and sufficient filters that were clean and without pinholes were
selected.
(ii)
All filters were equilibrated in
the conditioning environment for 24 hours before weighing. The conditioning
environment temperature was around 25 °C and not variable by more than ±3 °C;
the relative humidity (RH) was < 50% and not variable by more than ±5%. A
convenient working RH was 40%.
(iii)
All filter papers were prepared
and analysed by ALS Technichem
(HK) Pty Ltd., which is a HOKLAS accredited laboratory and has comprehensive quality assurance and quality control programmes.
(c)
Field
Monitoring
(i)
The power
supply was checked to ensure the HVS works properly.
(ii)
The filter holder and the area
surrounding the filter were cleaned.
(iii)
The filter holder was removed by
loosening the four bolts and a new filter, with stamped number upward, on a
supporting screen was aligned carefully.
(iv)
The filter was properly aligned
on the screen so that the gasket formed an airtight seal on the outer edges of
the filter.
(v)
The swing bolts were fastened to
hold the filter holder down to the frame.
The pressure applied was sufficient to avoid air leakage at the edges.
(vi)
Then the shelter lid was closed
and was secured with the aluminium strip.
(vii)
The HVS was warmed-up for about 5
minutes to establish run-temperature conditions.
(viii)
A new flow rate record sheet was
set into the flow recorder.
(ix)
On site temperature and atmospheric
pressure readings were taken and the flow rate of the HVS was checked and
adjusted at around 1.3 m3/min, and complied with the range specified
in the EM&A Manual (i.e. 0.6-1.7 m3/min).
(x)
The programmable digital timer
was set for a sampling period of 24 hrs, and the starting time, weather
condition and the filter number were recorded.
(xi)
The initial elapsed time was
recorded.
(xii)
At the end of sampling, on site
temperature and atmospheric pressure readings were taken and the final flow
rate of the HVS was checked and recorded.
(xiii)
The final elapsed time was
recorded.
(xiv)
The sampled filter was removed
carefully and folded in half length so that only surfaces with collected
particulate matter were in contact.
(xv)
It was then placed in a clean
envelope and sealed.
(xvi)
All monitoring information was
recorded on a standard data sheet.
(xvii)
Filters were then sent to ALS Technichem (HK) Pty Ltd. for analysis.
(d)
Maintenance
and Calibration
(i)
The HVS and its accessories were maintained in good working condition, such as
replacing motor brushes routinely and checking electrical wiring to ensure a
continuous power supply.
(ii)
HVSs were calibrated using
TE-5025A Calibration Kit upon installation and thereafter at bi-monthly
intervals.
(iii)
Calibration certificate of the TE-5025A Calibration Kit and the HVSs are provided in
Appendix
E.
(a)
Measuring Procedures
The measuring procedures of the 1-hour dust meter
are in accordance with the Manufacturer’s Instruction Manual as follows:
(i)
Turn the power on.
(ii)
Close the air collecting opening cover.
(iii)
Push the “TIME SETTING” switch to [BG]
(iv)
Push “START/STOP”
switch to perform background measurement for 6 seconds.
(v)
Turn the knob at SENSI ADJ position to insert
the light scattering plate.
(vi)
Leave the equipment for 1 minute upon “SPAN
CHECK” is indicated in the display.
(vii)
Push “START/STOP” switch to perform automatic
sensitivity adjustment. This measurement takes 1 minute.
(viii)
Pull out the knob and return it to MEASURE
position.
(ix)
Push the “TIME SETTING” switch the time set
in the display to 3 hours.
(x)
Lower down the air collection opening cover.
(xi)
Push “START/STOP” switch to start
measurement.
(b)
Maintenance and
Calibration
(i)
The 1-hour TSP meter
was calibrated at 1-year intervals against a continuous particulate TEOM
Monitor, Series 1400ab. Calibration certificates of the Laser Dust Monitors are
provided in Appendix
E.
Monitoring Schedule for the
Reporting Month
Monitoring Requirements
Table 3.3 Noise Monitoring Parameters,
Frequency and Duration
Parameter and Duration |
Frequency |
30-mins
measurement at each monitoring station between 0700 and 1900 on normal
weekdays. Leq, L10 and L90 would be
recorded. |
At least once per week |
Table 3.4 Noise Monitoring Equipment
for Regular Noise Monitoring
B&K (Model No. 2250-L & 2238) |
|
Acoustic
Calibrator |
B&K (Model
No. CAL21) |
Monitoring Locations
Table 3.5 Noise Monitoring
Stations during Construction Phase
Location |
Monitoring Station |
Description |
Measurement |
E-N12a [1] |
19 Hing Yan Street |
Rooftop (9/F) |
Façade |
E-N21a [1] |
Block B of Merit Industrial Centre |
Rooftop (13/F) |
Free field[2] |
Notes:
[1] The noise monitoring stations proposed in
the EM&A Manual (i.e. Grand Waterfront Tower 3 with ID: E-N12 and Hang
Chien Court Block J with ID: E-N21) were not available for impact noise
monitoring, therefore impact monitoring was conducted at E-N12a and E-N21a as
an alternative which was
agreed by the ER, IEC and EPD.
[2] A
correction of +3 dB(A) was made to the free field measurements.
Monitoring
Parameters, Frequency and Duration
Table 3.6 Noise Monitoring Parameters, Frequency and Duration
Location |
Parameter and Duration |
Frequency |
E-N12a
and E-N21a |
30-mins measurement at each
monitoring station between 0700 and 1900 on normal weekdays. Leq,
L10 and L90 would be recorded. |
At
least once per week |
Monitoring Methodology
(a)
The sound level meter was set on
a tripod at a height of 1.2 m above the ground.
(b)
Façade measurement was made at
E-N12a.
(c)
Free field measurements was made
at monitoring location E-N21a. A correction of +3 dB(A) shall be made to the
free field measurements.
(d)
The battery condition was checked to ensure the correct
functioning of the meter.
(e)
Parameters such as frequency
weighting, the time weighting and the measurement time were set as follows:
(i)
frequency weighting
(ii)
time weighting: Fast
(iii)
time measurement: Leq(30-minutes)
during non-restricted hours i.e. 0700 – 1900 on normal weekdays.
(f)
Prior to and after each noise
measurement, the meter was calibrated using the acoustic calibrator for 94
dB(A) at 1000 Hz. If the difference in
the calibration level before and after measurement was more than 1 dB(A), the
measurement would be considered invalid and repeat of noise measurement would
be required after re-calibration or repair of the equipment.
(g)
During the monitoring period, the
Leq, L10 and L90 were recorded. In addition, site conditions and noise
sources were recorded on a standard record sheet.
(h)
Noise measurement was paused
during periods of high intrusive noise (e.g. dog barking, helicopter noise) if
possible. Observations were recorded when intrusive noise was unavoidable.
(i)
Noise monitoring was cancelled in
the presence of fog, rain, wind with a steady speed exceeding 5m/s, or wind
with gusts exceeding 10m/s.
(a)
The
microphone head of the sound level meter was cleaned with soft
cloth at regular intervals.
(b)
The meter
and calibrator were sent to the supplier or HOKLAS laboratory to check and
calibrate at yearly intervals.
(c)
Calibration
certificates of the sound level meters and acoustic calibrators are
provided in Appendix E.
Monitoring Schedule for the
Reporting Month
Table 4.1 Status of Required Submission under Environmental Permit
EP Condition |
Submission |
Submission
Date |
Condition 3.4 of |
Monthly EM&A Report
for December 2020 |
14 January 2021 |
Table 5.1 Summary of 24-hour
TSP Monitoring Result in the Reporting Period
ID |
Average (mg/m3) |
Range (mg/m3) |
Action Level (mg/m3) |
Limit Level (mg/m3) |
E-A14a |
80.4 |
62.5 – 114.3 |
197.3 |
260 |
Table 5.2 Summary of 1-hour TSP
Monitoring Result in the Reporting Period
ID |
Average (mg/m3) |
Range (mg/m3) |
Action Level (mg/m3) |
Limit Level (mg/m3) |
E-A14a |
55.3 |
52.3
– 63.7 |
302.4 |
500 |
Table 5.3 Summary of
Construction Noise Monitoring Results in the Reporting Period
ID |
Range, dB(A), Leq (30 mins) |
Limit Level, dB(A), Leq
(30 mins) |
E-N12a1 |
58.9
– 59.7 |
75 |
E-N21a |
59.6
– 61.3 |
75 |
Remark: 1.
As the sewage sampling was tested positive for COVID-19 near the noise
monitoring location at 19 Hing Yan Street (E-N12a). Therefore, the impact
noise monitoring at this location will be provisionally suspended for 14
days. (From 27 January 2021 to 9 February 2021) |
Table 6.1 Observations and Recommendations of Site Audit
Parameters |
Date |
Observations and Recommendations |
Follow-up |
Air Quality |
15 January 2021 |
· Haul road was observed to be dry at Kai Tak. The Contractor
should enhance the frequency of water spraying for dust suppression. |
The item was rectified by the
Contractor on 18 January 2021. |
Noise |
6 January 2021 |
· Acoustic mat was not observed on the drill rig at Ma Tau
Kok. The Contractor was reminded to place the acoustic mat on drill rig for
noise screening. |
The item was rectified by the
Contractor on 8 January 2021. |
27 January 2021 |
· Generator was observed operated without noise barrier at
Ma Tau Kok. The Contractor should be erected the noise barrier around the
generator for noise screening. |
The item was rectified by the
Contractor on 3 February 2021. |
|
Water Quality |
Nil |
Nil |
Nil |
Waste/ Chemical Management |
6 January 2021 |
· Chemical containers were observed stored without drip tray
at Marine Platform and Kai Tak Barging Point. The Contractor was reminded to
provide a drip tray for chemical storage. |
The item was rectified by the
Contractor on 12 January 2021. |
15 January 2021 |
· Chemical containers were observed stored without drip tray
at Depress Road in Kai Tak. The Contractor should provide proper handling for
chemical storage. |
The item was rectified by the
Contractor on 19 January 2021. |
|
20 January 2021 |
· Chemical container was observed without the secondary
containment at Ma Tau Kok. The Contractor was reminded to provide the
secondary containment to prevent accidental spillage. |
The item was rectified by the
Contractor on 26 January 2021. |
|
27 January 2021 |
· General refuse was observed accumulated on the ground at
underpass in Kai Tak. The Contractor should remove the general refuse
regularly to maintain the site tidiness. |
The item was rectified by the
Contractor on 3 February 2021. |
|
Landscape & Visual |
Nil |
Nil |
Nil |
Permits/ Licenses |
Nil |
Nil |
Nil |
Table 8.1 Construction Activities in the coming three months
Locations |
Site Activities |
Kai
Tak |
·
Wall and roof slab construction at cut & cover,
underpass and depressed road; ·
Backfilling works and ELS removal at cut & cover,
underpass and depressed road; ·
Dismantle of working platform. |
Ma
Tau Kok |
·
TTM implementation; ·
Pipe piling works for cut and cover tunnel east portion; ·
Trial trench for piling works; ·
Fresh water pipe installation works; ·
Temporary storm drain diversion works; ·
Demolition of Kowloon City Public Pier. |
Kowloon
Bay |
·
Backfilling and ELS removal works; ·
Roof slab and wall construction; ·
Waterproofing application; ·
Preparation works for Stage 2 UWT. |
Barging
Point |
·
Demolition of Kai Tak Barging Point. |
